The decision
Test the consequences of a material change before the project commits to it.

Project decision assurance for major projects
When a live change pulls design, cost and programme apart, Clockwork helps Project Directors and senior project sponsors reconcile the evidence, test the credible options and see the consequences before committing.
The result is a decision your team can act on — and you can explain and defend.
Coordinated project deliverables
The project problem
A change rarely affects one drawing. It moves through design, quantities, cost, sequence, programme and approvals. Clockwork keeps those consequences connected—and carries the approved decision into verified project artefacts.
Flagship case study · Mitre Wharf
A major design change does not stay in the model. It changes quantities, construction logic, package prices, programme dependencies, risk and the decision the Project Director must own.
Test the consequences of a material change before the project commits to it.
Reconcile contractor and specialist subcontractor prices and programmes with BCIS benchmarks and the overall build cost normalised by GIFA.
Show how the option moves design, cost, programme and risk, with the basis and uncertainty visible for the accountable decision-maker.

Governed cost output
A public-safe extract showing how project geometry becomes classified NRM2 quantities and cost information.

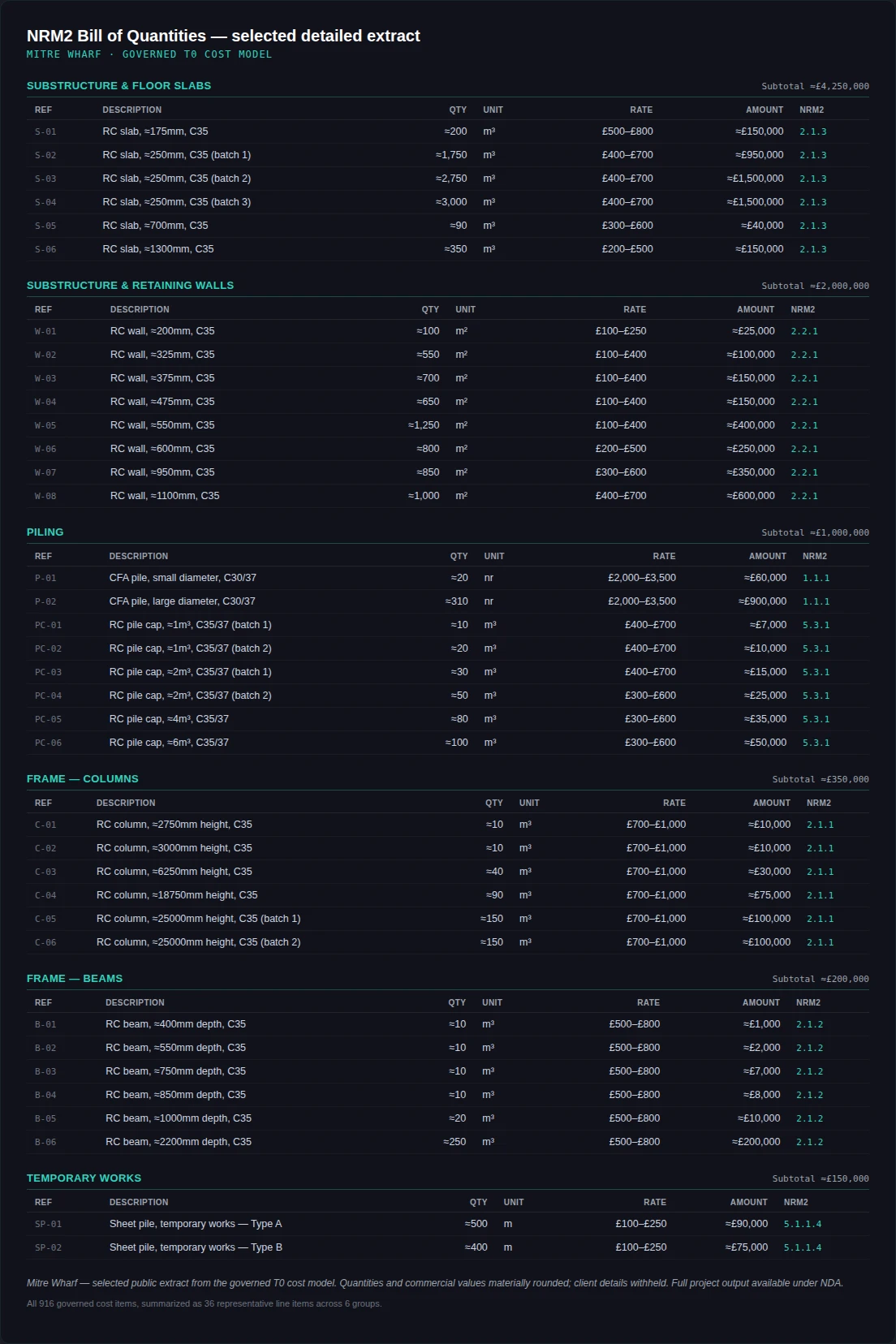

Case-study extract from the governed Mitre Wharf cost model. It combines contractor tender inputs with governed benchmark rates; quantities and commercial values are materially rounded and client details withheld. View full size ↗
All 916 governed cost items, summarized as 36 representative line items across 6 groups.
Define what matters for the decision: design performance, buildability, cost, programme, carbon, risk or another project-specific measure.
Develop and compare viable options using agreed evidence, assumptions and weighting.
Present the consequences clearly so the responsible project team can make and approve an informed decision.
Develop the selected option and update the drawings, specifications, reports, quantities and programme information affected by it.
One decision, carried consistently through the project information.
Clockwork appointments are built around useful project outputs, not a software licence. The exact package is agreed around the project stage, decision and responsibilities.
Bring the live decision and the information you already have. Clockwork reconciles the evidence, tests the credible options and returns a concise basis for action.
If the decision needs deeper development, continue into an Option Test or a Verified Decision Pack.
Evidence from live project work
Real programme, site and engineering evidence showing how Clockwork makes project consequences visible enough to review and act on.

Mitre Wharf

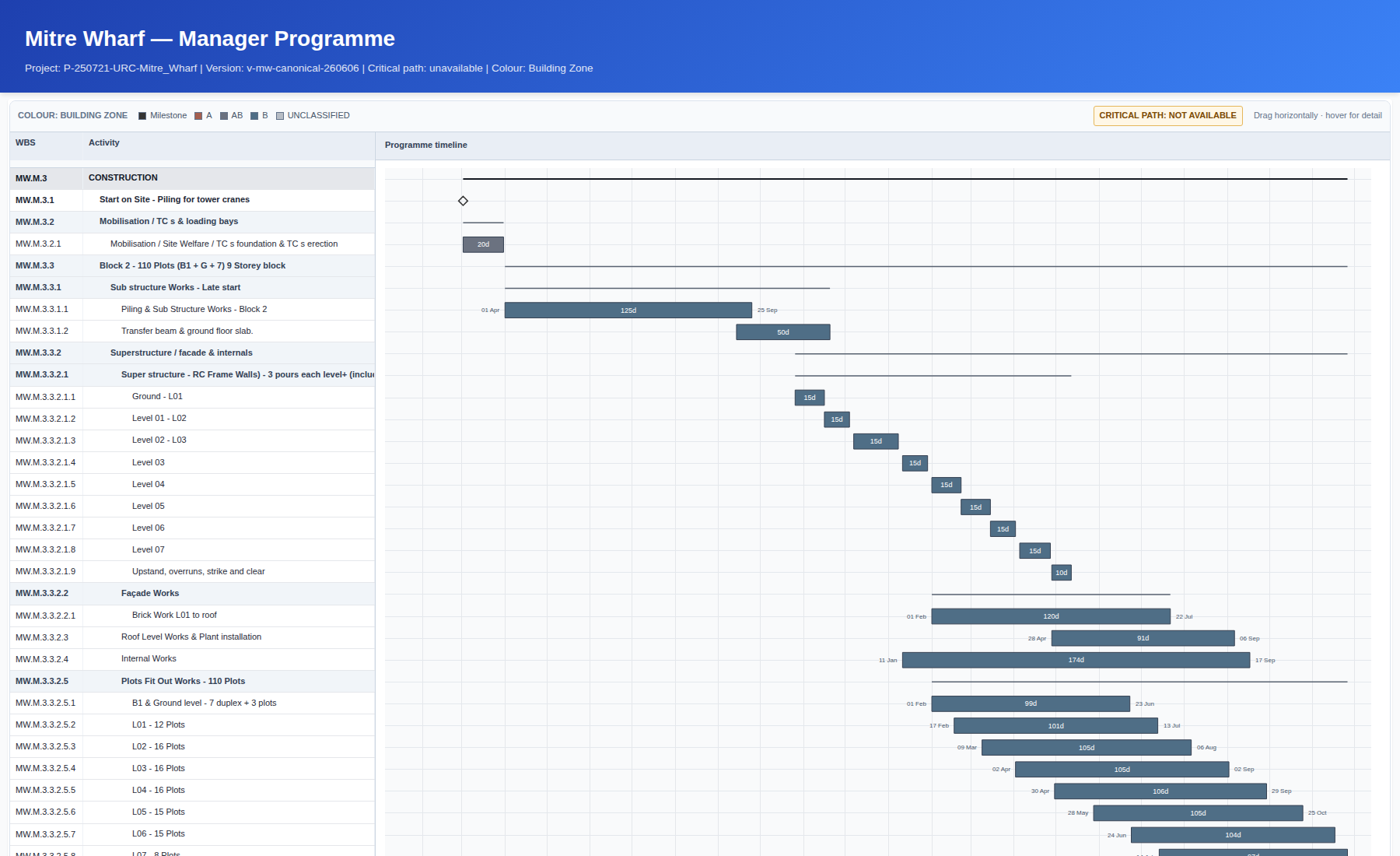

A real programme view used to inspect hierarchy, dates and bars, and to see where a decision propagates into delivery.
Open full-resolution evidenceReal programme evidence

River Wall Retrofit

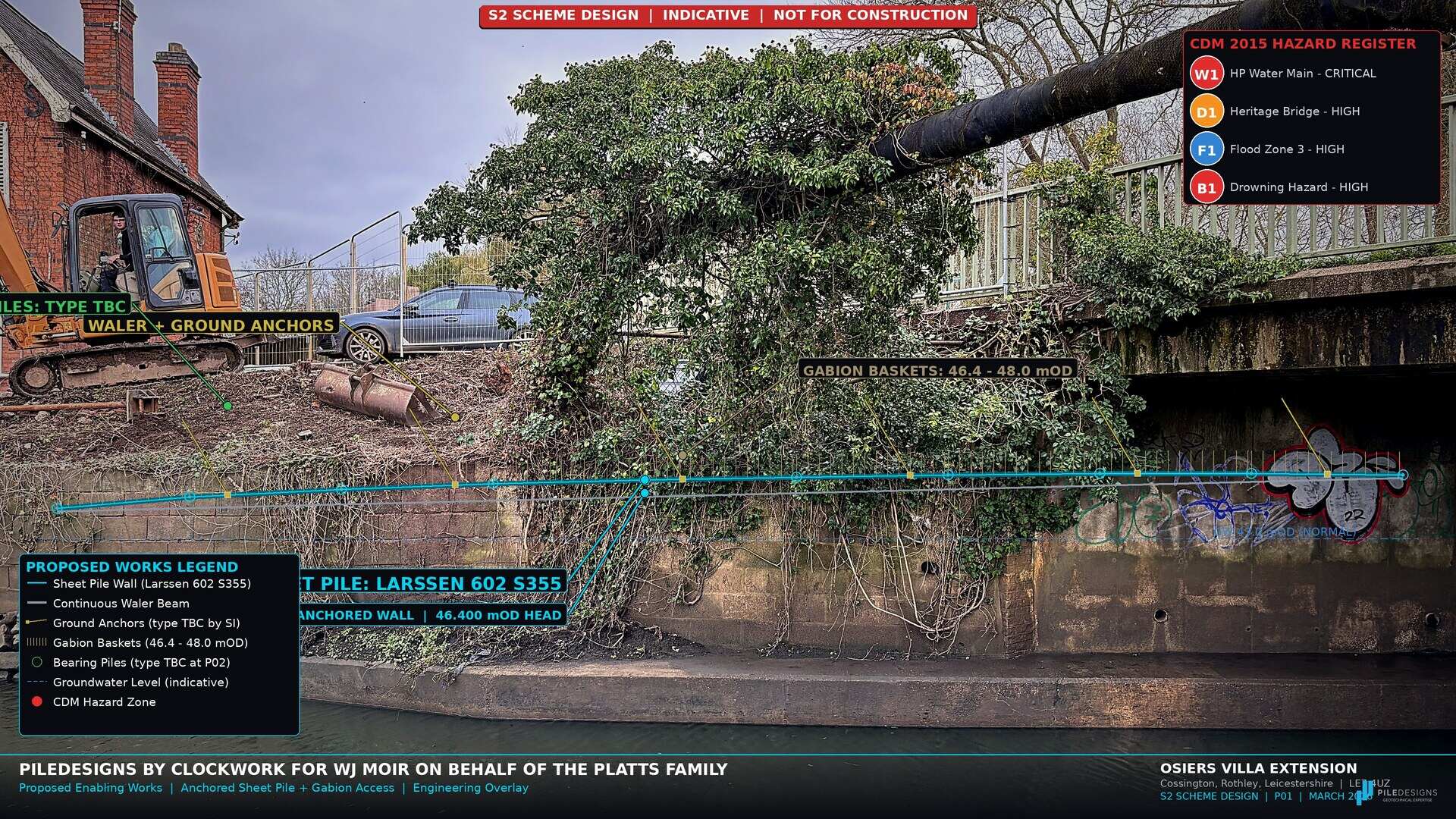

Clockwork’s proposed sheet-pile wall, anchors and interfaces set directly against the existing river-wall condition.
Open full-resolution evidenceSite and design evidence

Greater Fernwood

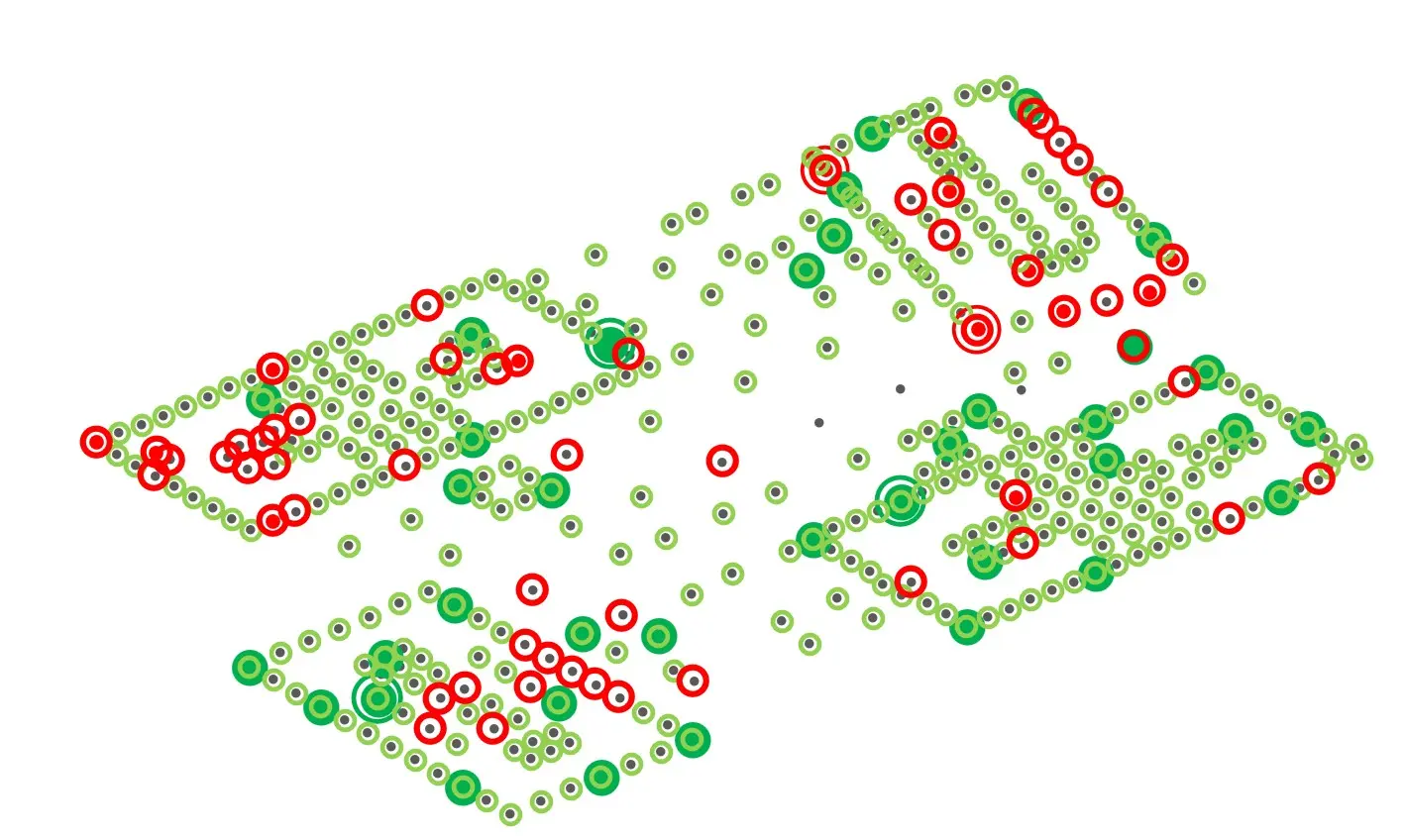

A 167-pile demand and capacity check plots the project loads against the calculated interaction envelope: 151 PASS and 16 FAIL.
Open full-resolution evidenceEngineering check

Swinnow

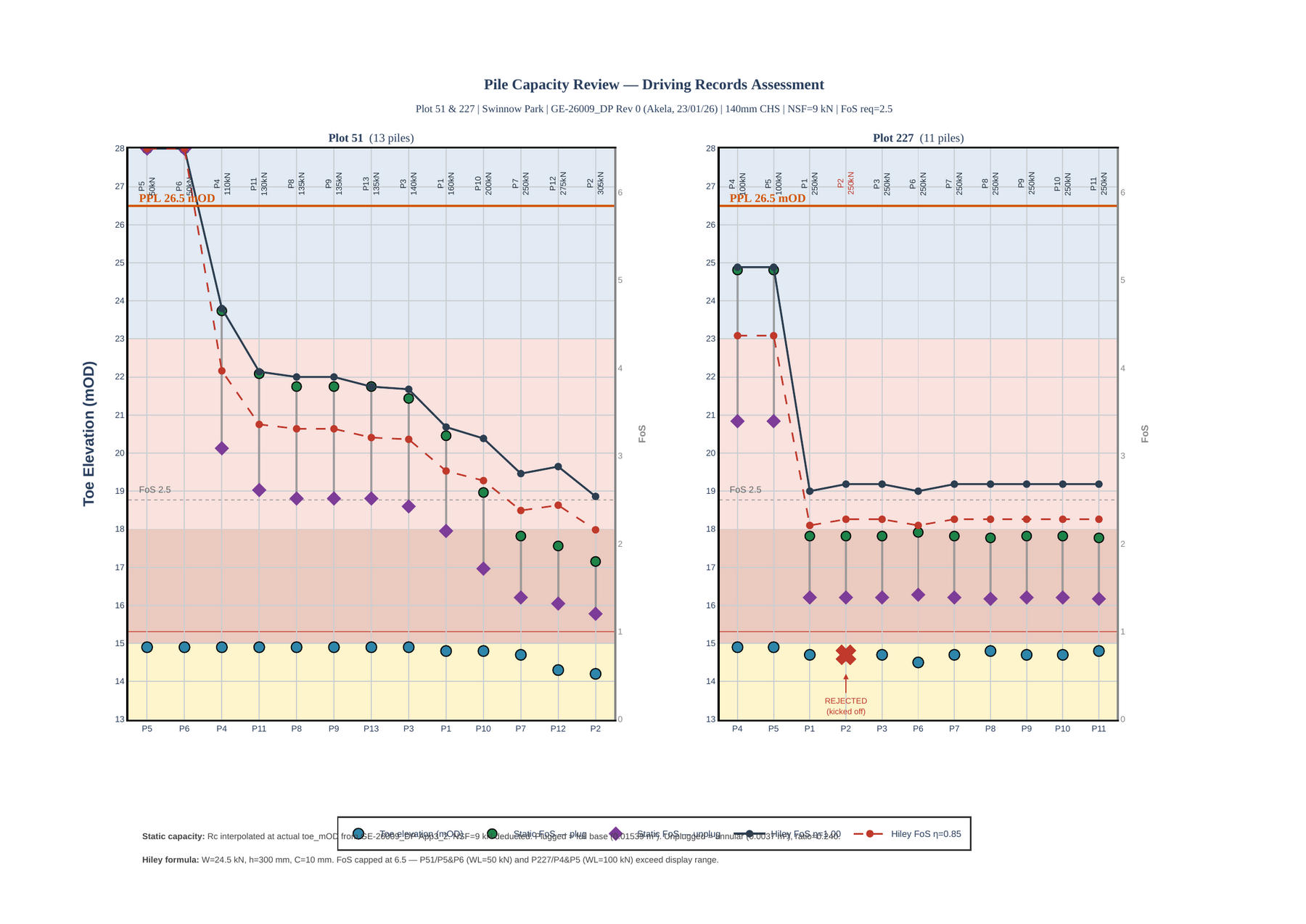

Pile capacity calculations are compared with recorded installation behaviour; driving-record exceptions are under review.
Open full-resolution evidenceConstruction record check

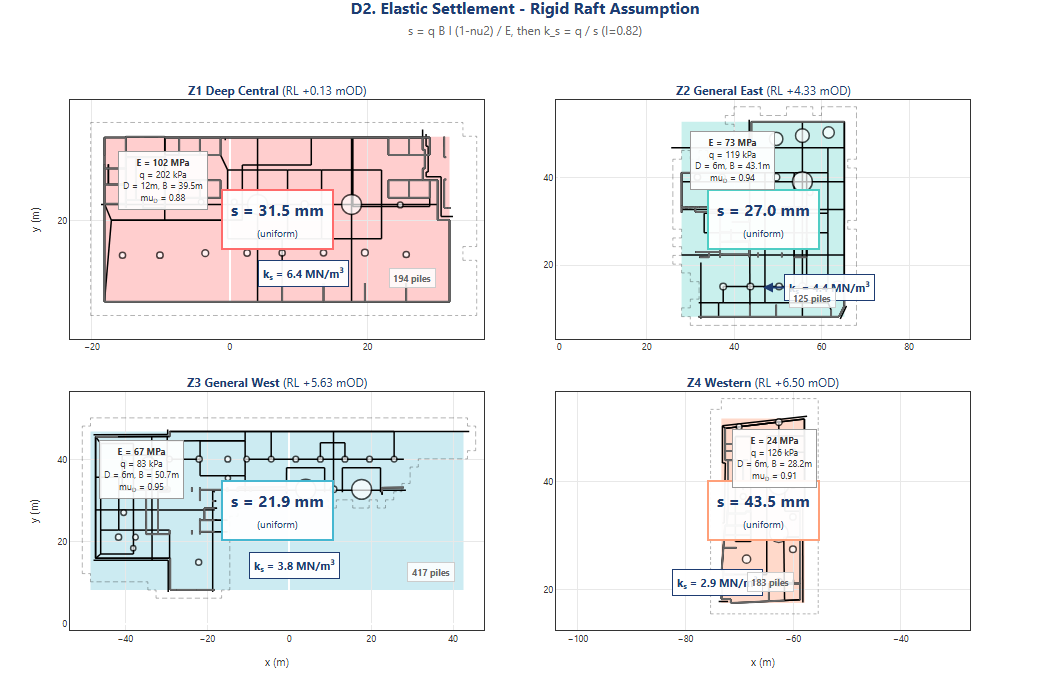

Foundation response comparison

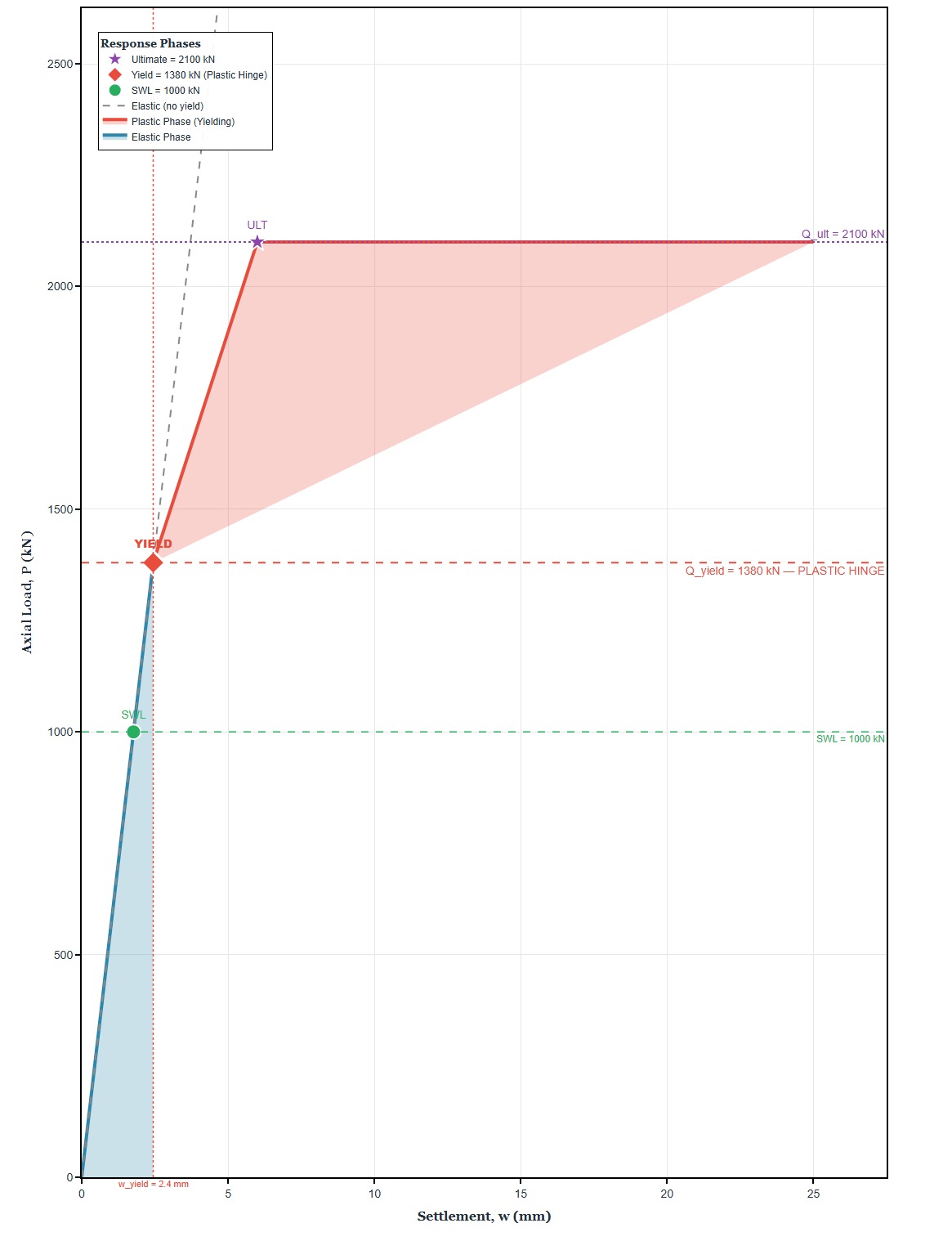

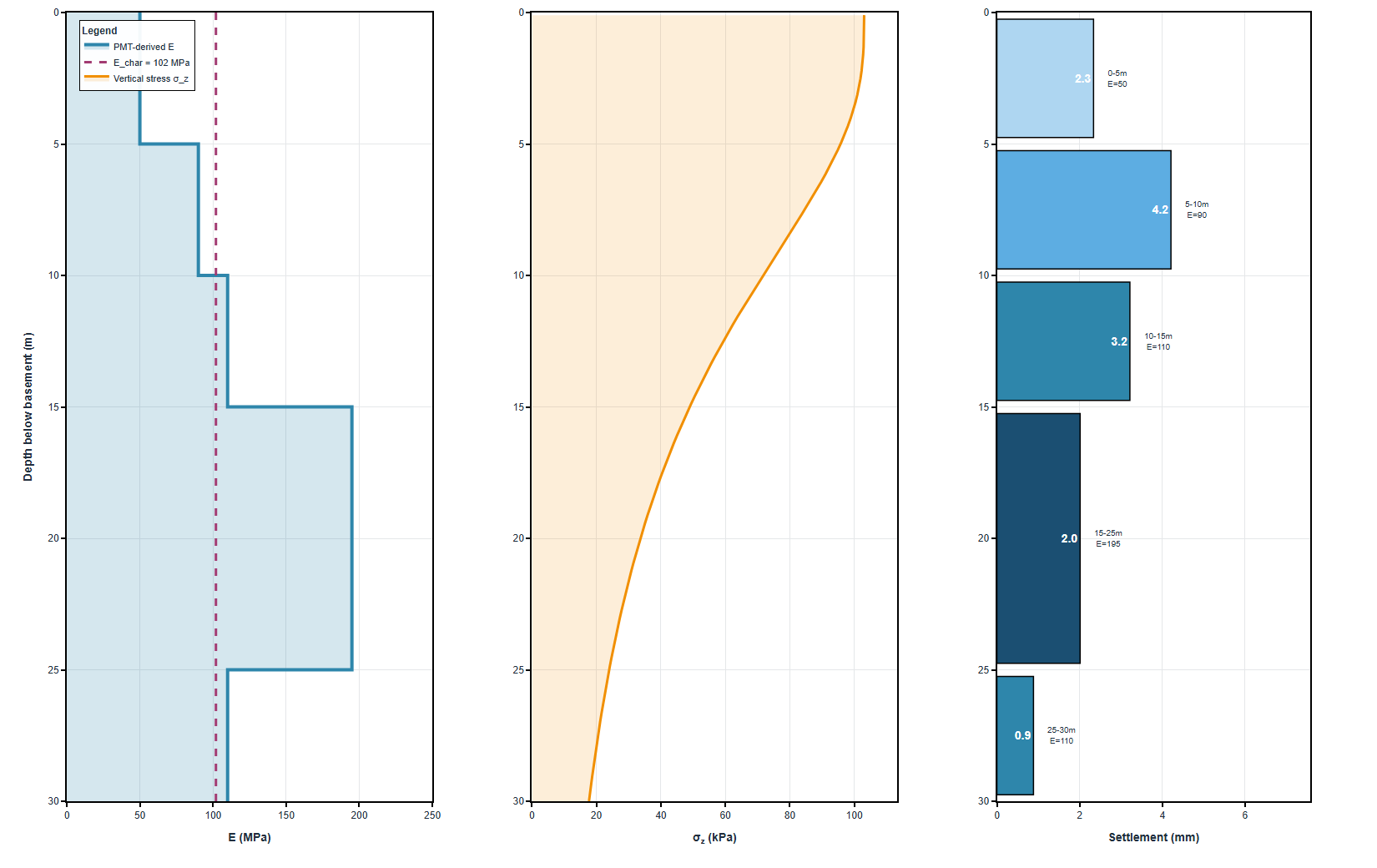

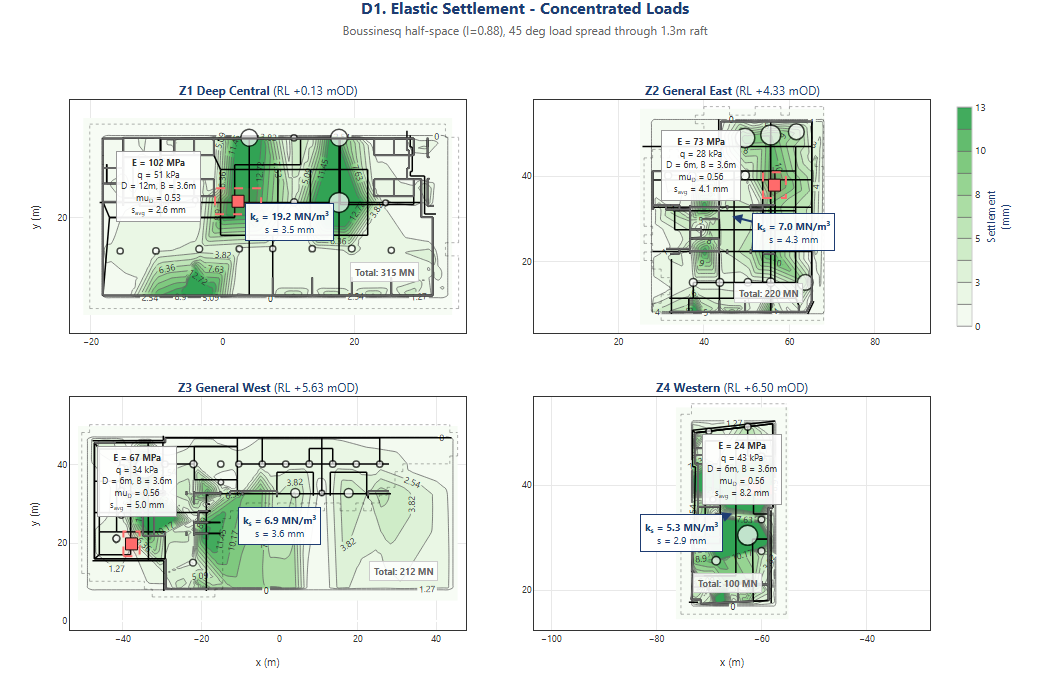

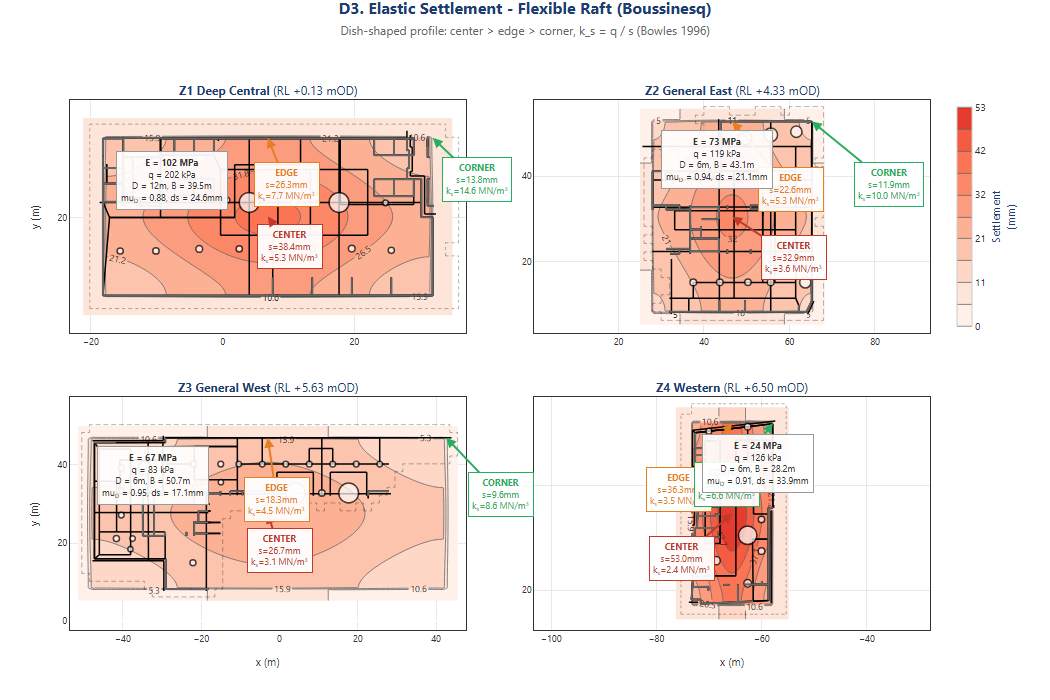

Three modelling assumptions are compared to expose how predicted foundation response changes, making the sensitivity of the result visible for engineering review.

Clockwork uses connected digital workflows, calculation tools and selected AI systems to accelerate analysis and production. Professional judgement, review and approval remain with the responsible construction team.

Director
Director, Clockwork Consultancy
25 years delivering structural, geotechnical and construction engineering on projects across the UK and internationally
Experience includes: Google HQ · South Quay Plaza · Edinburgh St James
Previous employers and project teams.
Tell us what must be decided, when it must be decided and who is accountable. We will define a focused first commission around the evidence available.
